The Admin. Order n.103 of 20 July 2021, converted into law n.125 of 16 September 2021, declares the urban waterways of San Marco Basin, San Marco Canal and Giudecca Canal of Venice a national monument. In these waterways, starting from 1 August 2021, the transit of ships having at any one of the following characteristics is prohibited: a) gross tonnage exceeding 25,000 GT; b) hull length at waterline greater than 180 metres; c) height from the waterline (air draft) greater than 35 metres, excluding ships with mixed sail - engine propulsion; (4) d) use of fuel during manoeuvering with sulphur content equal to or greater than 0.1 per cent.
In this context, Admin.Order 103 charges the Special Commissioner with the task of proceeding:
Point 1

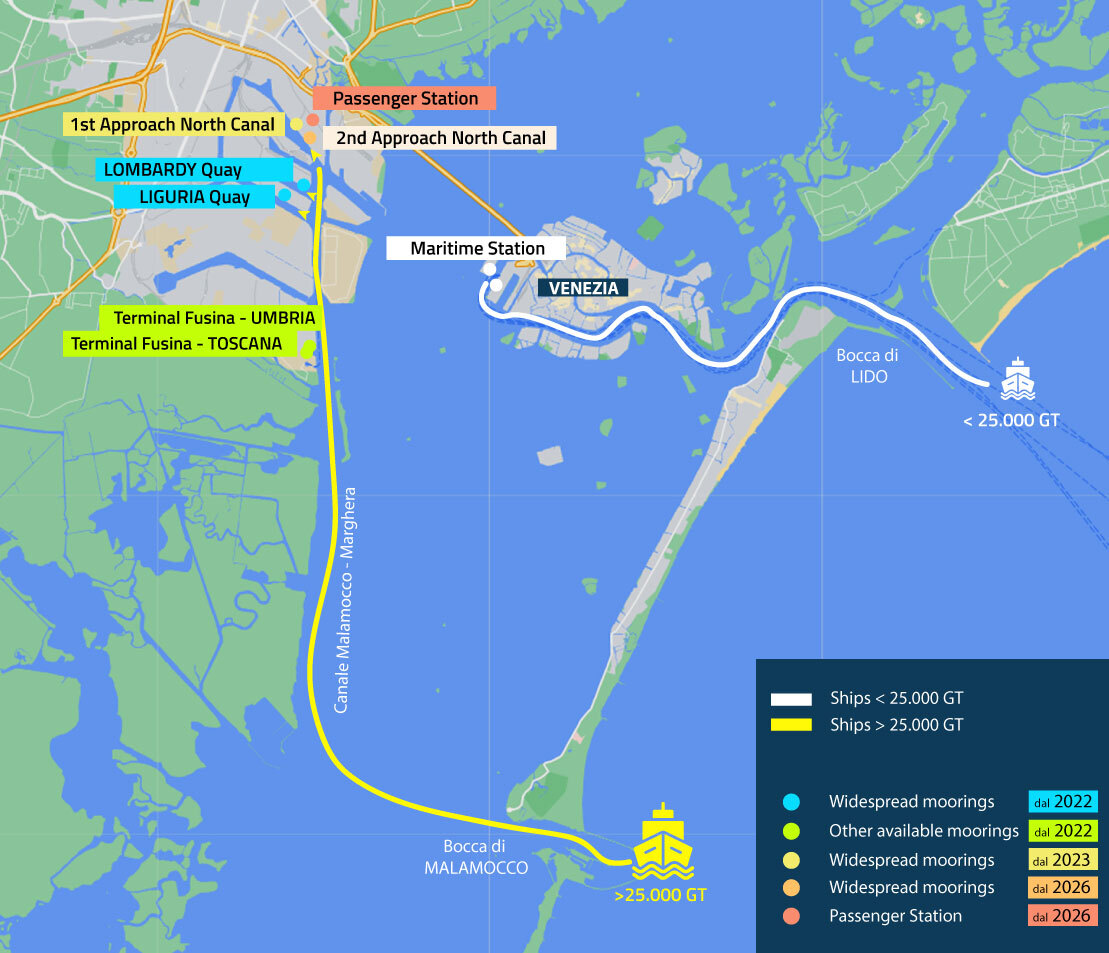

Creation of temporary mooring points
no more than 5, of which 2 are already available from the 2022 cruise season, plus the Chioggia quay, also intended for passenger ships of a gross tonnage equal to or greater than 25,000 GT
Point 2
Maintenance of existing canals
Works and maintenance excavations of existing canals to allow navigation.
Point 3
Accessory interventions
Accessory interventions to improve nautical accessibility and navigation safety.
Point 4
Promotion of studies
Promotion of hydrogeological, geomorphological and archaeological studies aimed at protecting Venice and its Lagoon.
Timetable
-
March 29, 2022
-
March 29, 2022Activity year 2022
Completion of first mooring upgrade, Liguria Quay
Completion of second mooring upgrade, Lombardy Quay
An additional mooring is operational in Chioggia
Conclusion of the nautical accessibility study of Canale Malamocco -Marghera
Design and award of works for equipping temporary mooring in the North canal
Improvement of the Chioggia quay – Isola Saloni
Approval of the feasibility project for the North Canal and Passenger Station approaches
Planning the improvement of usability and safety of the Liguria and Lombardy quays
-
March 29, 2022Activity year 2023
Start of canal maintenance planning
Awarding of the final design for the Passenger Station
Approval of the design of the North Canal and Passenger Station moorings
Approval of the canal maintenance project
Start of planning interventions to improve nautical accessibility
Completion of planning for the improvement of usability and safety at the Liguria and Lombardy quays
Delivery of the North Canal temporary mooring
-
March 29, 2022
-
March 29, 2022
-
March 29, 2022
Economic resources
The following expenses are authorized for carrying out and executing the activities under the responsibility of the Commission:
2 ml €
2021
9 ml €
2022
15 ml €
2023
42 ml €
2024
55 ml €
2025
35 ml €
2026
